CCCT Project Updates

Upcoming project work:

Week of April 1st

Cross County Connector Trail Update-
SHA District-2 has agreed to REVISE the permit day time closures of exit ramp 42 to 7am to 5pm (These closures will not be permitted during peak season beginning in May).  Ramp closure for pile installation will be in place until the end of April, depending on weather and site conditions.

Extending the ramp closure time may reduce the number of days required for this exit ramp closure.   After the exit ramp closure is removed, flagging operations will be required along Kent Narrows Road to supply materials for the boardwalk construction.

 Since the exit ramp closure, pile driving has started at both ends of project.  Several piles and boardwalk stringers have been installed along the Kent Narrows Road and the east end of the project.

 Status of Project Completion as of 4.03.19:
 Pile installation   48 %
 Stringer installation 2,000 LF
 Decking installation   300 LF

Week of March 25th

SHA District-2 has agreed to permit day time closures of exit ramp 42 from 7 am to 3 pm.  (These closures will not be permitted during peak season beginning in May).  Ramp closure for pile installation will be in place for approximately 20 working days, depending on weather and site conditions.

Monday, March 25- Day time closures of exit ramp 42 from 7 am to 3 pm will start on this day.  Delmarva Power will temporarily remove the existing overhead street lighting electric wire on Monday March 25th.  There will be no street lighting along Kent Narrows Road for approximately three weeks.  A temporary construction entrance (SCE) will be installed and tree removal in the work zone.

Tuesday, March 26- Pile installation will begin along Kent Narrows Road for approximately 20 working days depending on weather and site conditions.

Week of April 22

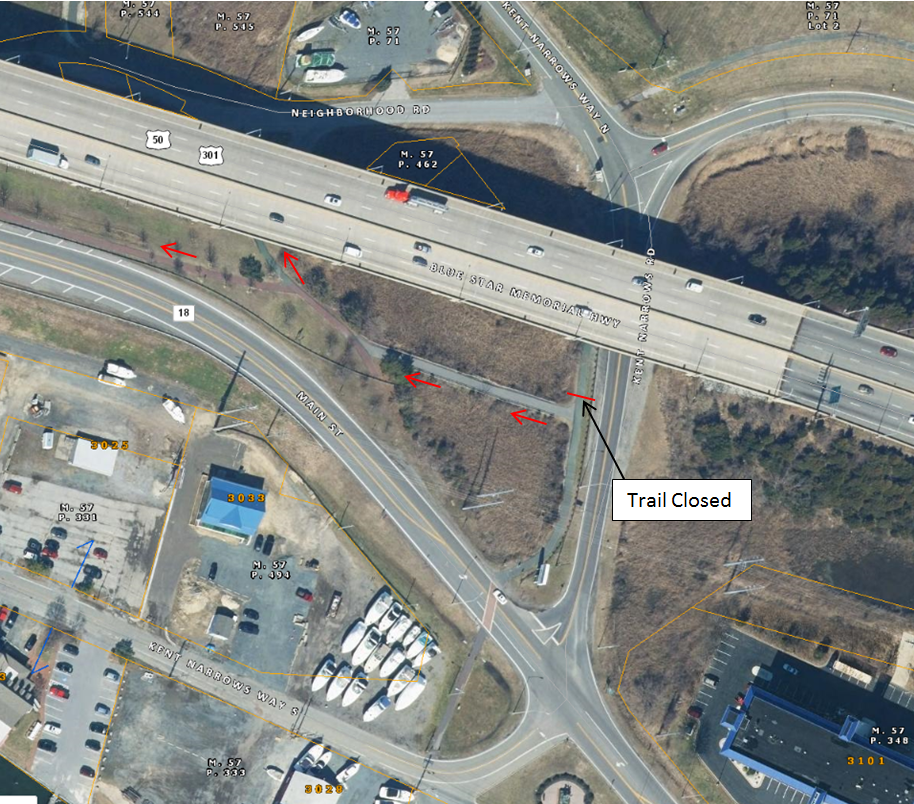

Week of April 22nd  - pile driving along the Kent Narrows Road should be completed (again depending on weather and site conditions), contractor will be removing SCE and cleaning up the work zone.  The boardwalk decking installation for this area will not require any road closures.


Project Status Updates

03.20.19 Status of Project Completion

Pile installation         27%

Stringer installation   1,200 LF

Decking installation   100 LF
